Chapter 10: Quality & Acceptance

Security Systems Lightning Protection and Grounding Design Guide


10.1 Quality Comparison: Compliant vs. Non-Compliant Installation

The quality of a security system lightning protection installation can vary dramatically depending on the workmanship, material quality, and adherence to design specifications. The photograph below illustrates the key visual differences between a compliant, high-quality installation and a non-compliant installation with common defects. These differences are not merely aesthetic — each defect represents a measurable reduction in protection effectiveness that will manifest as equipment damage during the next significant storm event.

Quality control during installation is significantly more cost-effective than post-damage remediation. The cost of replacing a single NVR or network switch typically exceeds the cost of the SPD and bonding materials that would have prevented the damage. Systematic inspection using the checklist in Section 10.3 ensures that quality issues are identified and corrected before commissioning, not after the first storm.

Quality Comparison - Compliant vs Non-Compliant Lightning Protection Installation

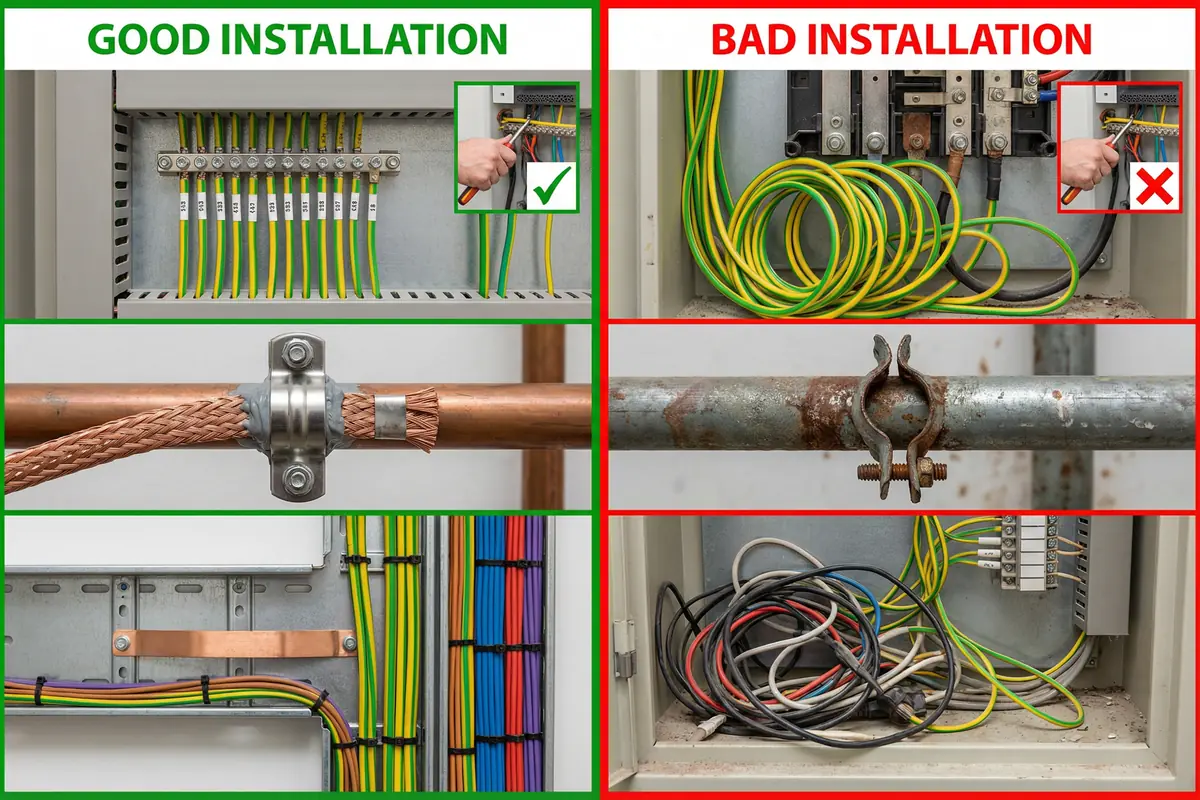

Figure 10.1: Quality Comparison — Compliant Installation (left: labeled bonding conductors, short SPD earth leads, bonded trays, anti-corrosion paste) vs. Non-Compliant (right: long coiled earth leads, missing jumpers, corroded clamps, unlabeled connections)

10.2 Acceptance Test Procedures

Acceptance testing for security system lightning protection is organized into four test groups that must be completed in sequence. Each test group builds on the results of the previous group — it is not meaningful to test SPD coordination before verifying that the bonding and grounding infrastructure is compliant. The test sequence reflects the physical hierarchy of the protection system, from the grounding electrode system at the foundation through to the device-level functional tests at the top.

Test Group 1: Grounding Electrode System

Test Method Pass Criterion Instrument Documentation
Ground resistance (main GES) 3/4-pole fall-of-potential; correct probe spacing R_E ≤ 4 Ω (or local code) Ground resistance tester (calibrated) Test report with probe positions, soil conditions, date
Ground resistance (field poles) 3-pole fall-of-potential at each pole R_E ≤ 10 Ω (remote sites) Ground resistance tester Test report per pole; GPS coordinates
MEB to GES continuity 4-wire micro-ohmmeter; test link disconnected < 0.1 Ω Micro-ohmmeter (calibrated) Test report; photo of test link position
Test link accessibility Visual inspection Accessible; labeled; disconnectable Visual Photo

Test Group 2: Equipotential Bonding

Test Method Pass Criterion Instrument Documentation
Equipment rack to MEB 4-wire micro-ohmmeter; rack frame to MEB terminal < 0.1 Ω per bond Micro-ohmmeter Test report; photo of each connection
Cable tray continuity 4-wire micro-ohmmeter; end-to-end along tray run < 0.1 Ω end-to-end Micro-ohmmeter Test report; tray run identification
Field cabinet to LEB 4-wire micro-ohmmeter; cabinet body to LEB < 0.1 Ω Micro-ohmmeter Test report per cabinet
Outdoor pole to GES 4-wire micro-ohmmeter; pole base to GES < 0.1 Ω Micro-ohmmeter Test report per pole
SPD earth lead length Physical measurement ≤ 0.5 m preferred; no coils Tape measure Photo; note any exceptions
Bonding conductor labeling Visual inspection against as-built drawings All conductors labeled at both ends Visual Photo; checklist

Test Group 3: SPD Installation & Coordination

Test Method Pass Criterion Instrument Documentation
SPD location vs. design Compare as-built to SPD location map All specified SPDs installed at correct locations Visual + drawings Marked-up as-built drawing
SPD status indicators Visual inspection of all SPD status indicators All indicators show normal/green status Visual Photo of each SPD panel
SPD Up coordination Datasheet review; compare Up values Type 1→2→3 Up decreasing; Type 3 Up < equipment Uw Datasheets SPD schedule with Up values
PoE SPD compatibility PoE load test at full port count No PoE drops; link at correct speed PoE tester / switch port statistics Test report; port statistics screenshot
Data SPD insertion loss Link speed negotiation check; error counter Link at correct speed; error counter < threshold Network switch CLI Screenshot of port statistics

Test Group 4: System Functional Tests

Test Method Pass Criterion Instrument Documentation
Network performance iPerf throughput test; ping latency test Throughput ≥ design spec; latency within spec iPerf; ping Test report with results
Video quality baseline Visual inspection of all camera feeds No interference patterns; correct resolution VMS client Screenshot per camera
Alarm system baseline Monitor false alarm rate over 7-day period False alarm rate within project KPI Alarm management system Alarm event log report
Cable routing inspection Physical inspection of all cable routes Separation maintained; no unauthorized copper runs Visual + tape measure Inspection checklist; photos of exceptions
Documentation completeness Document audit against required list All required documents present and current Document checklist Document register

10.3 Acceptance Checklist Summary

The acceptance checklist provides a structured record of all acceptance test results, enabling the project team to track progress toward commissioning and identify outstanding items. The checklist must be completed by a qualified engineer and signed off by both the installing contractor and the client representative before the system is handed over for operation.

# Acceptance Item Pass Criterion Status
1Ground resistance (main GES)R_E ≤ 4 Ω[ ] Pass [ ] Fail [ ] N/A
2Ground resistance (field poles)R_E ≤ 10 Ω[ ] Pass [ ] Fail [ ] N/A
3MEB to GES continuity< 0.1 Ω[ ] Pass [ ] Fail [ ] N/A
4Equipment rack bonding continuity< 0.1 Ω per bond[ ] Pass [ ] Fail [ ] N/A
5Cable tray continuity< 0.1 Ω end-to-end[ ] Pass [ ] Fail [ ] N/A
6Field cabinet bonding continuity< 0.1 Ω[ ] Pass [ ] Fail [ ] N/A
7Outdoor pole bonding continuity< 0.1 Ω[ ] Pass [ ] Fail [ ] N/A
8SPD earth lead length≤ 0.5 m; no coils[ ] Pass [ ] Fail [ ] N/A
9All SPDs installed per designLocation map match[ ] Pass [ ] Fail [ ] N/A
10All SPD status indicators normalAll green/normal[ ] Pass [ ] Fail [ ] N/A
11SPD Up coordination verifiedDecreasing Type 1→2→3[ ] Pass [ ] Fail [ ] N/A
12PoE SPD compatibilityNo drops; correct speed[ ] Pass [ ] Fail [ ] N/A
13Network performanceThroughput and latency within spec[ ] Pass [ ] Fail [ ] N/A
14Video quality baselineNo interference[ ] Pass [ ] Fail [ ] N/A
15Alarm false alarm rate baselineWithin project KPI[ ] Pass [ ] Fail [ ] N/A
16Cable routing inspectionSeparation maintained[ ] Pass [ ] Fail [ ] N/A
17Bonding conductor labelingAll labeled at both ends[ ] Pass [ ] Fail [ ] N/A
18As-built documentation completeAll documents present[ ] Pass [ ] Fail [ ] N/A

Acceptance Principle: All items in the acceptance checklist must achieve "Pass" status before the system is handed over. "Fail" items must be corrected and re-tested. "N/A" items must be justified in writing. Partial acceptance (accepting a system with outstanding "Fail" items) creates documented liability for the installing contractor and unacceptable risk for the client.
